Share Project update: December 12, 2024 on Facebook
Share Project update: December 12, 2024 on Linkedin
Email Project update: December 12, 2024 link

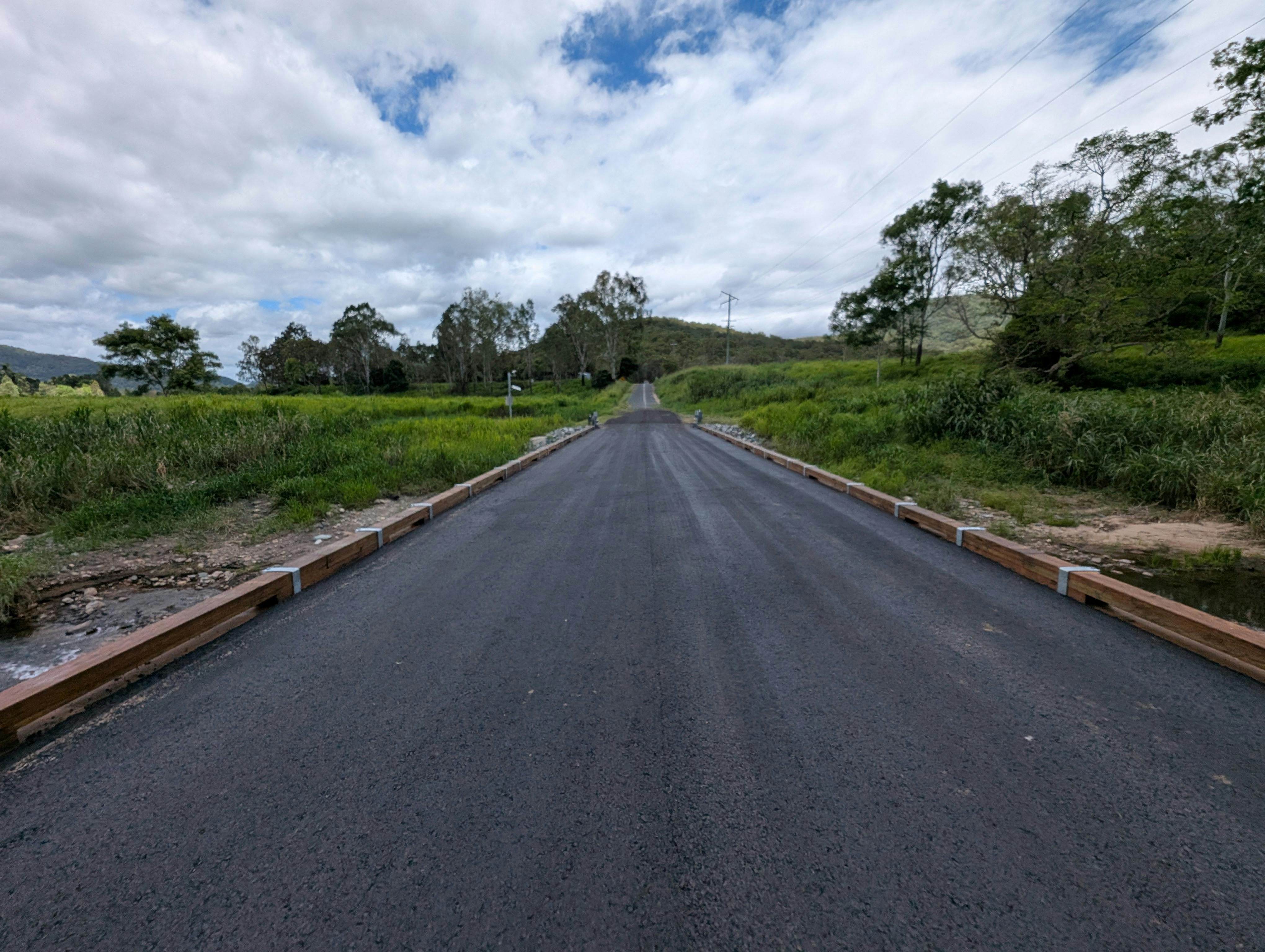

Detour route closed due to flooding

Multiple sections of Calen-Mount Charlton Road, both north and south of Cameron’s Pocket, are temporarily closed due to flooding.
Motorists are urged to avoid the road if possible.
Residents should limit travel. If travel is necessary, drive to the road conditions and follow all roadside signage.
If it’s flooded, forget it.
Opt-in to receive notifications about road closures and other emergency events at disaster.mackay.qld.gov.au
Share Project update: November 25, 2024 on Facebook
Share Project update: November 25, 2024 on Linkedin
Email Project update: November 25, 2024 link
Barren Creek Bridge completion is delayed
The works by Timber Restoration Systems (TRS) are progressing well. The substructure is complete and scour protection works are under way.
Unfortunately, the custom-built deck has been held in Customs causing a delay to the re-opening. Council and TRS have investigated other options to minimise further delays and, as a result, a new deck is being constructed at no additional expense to council.
The work is now expected to be completed by late February 2025, weather permitting.
Detours will remain in place via Barren Creek Road to Barren Pocket Road or via Mirani-Mount Ossa Road.
Please continue to drive to the road conditions and follow all roadside signage.
We apologise for any inconvenience. Should you require any further information, please contact 1300 MACKAY (622 529).
Share Project update: November 14, 2024 on Facebook
Share Project update: November 14, 2024 on Linkedin
Email Project update: November 14, 2024 link
The restoration of Palm Tree Creek Bridge at Pinnacle has been completed.

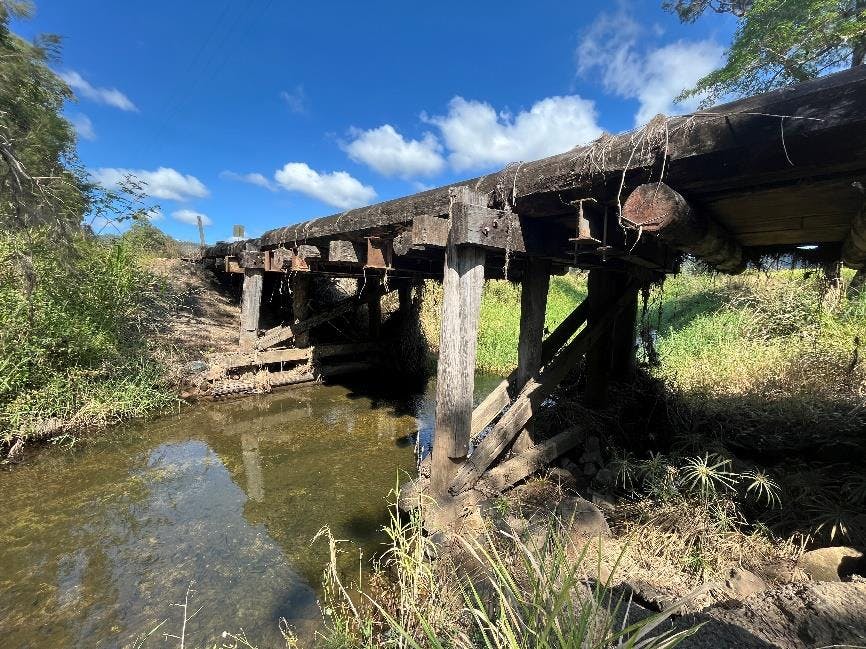

Works by contractor Timber Restoration Systems to replace Palm Tree Creek Bridge, on Walker-Finns Road, were completed on Wednesday, October 23, 2024.
Following the demolition of the bridge in May 2024, the foundations were found to be in poorer condition than anticipated. Works ceased on site while engineers completed a new design and a concreting sub-contractor was engaged. Works then re-commenced in August 2024.
The following has been completed as part of this project:
- Concrete foundations and approach slabs.
- Scour protection to the creek, to protect the structural foundations in future flood events.
- New Australian hardwood timber structure and galvanised steel fixings.
- Glue laminated timber deck.
- Asphalt wearing surface.

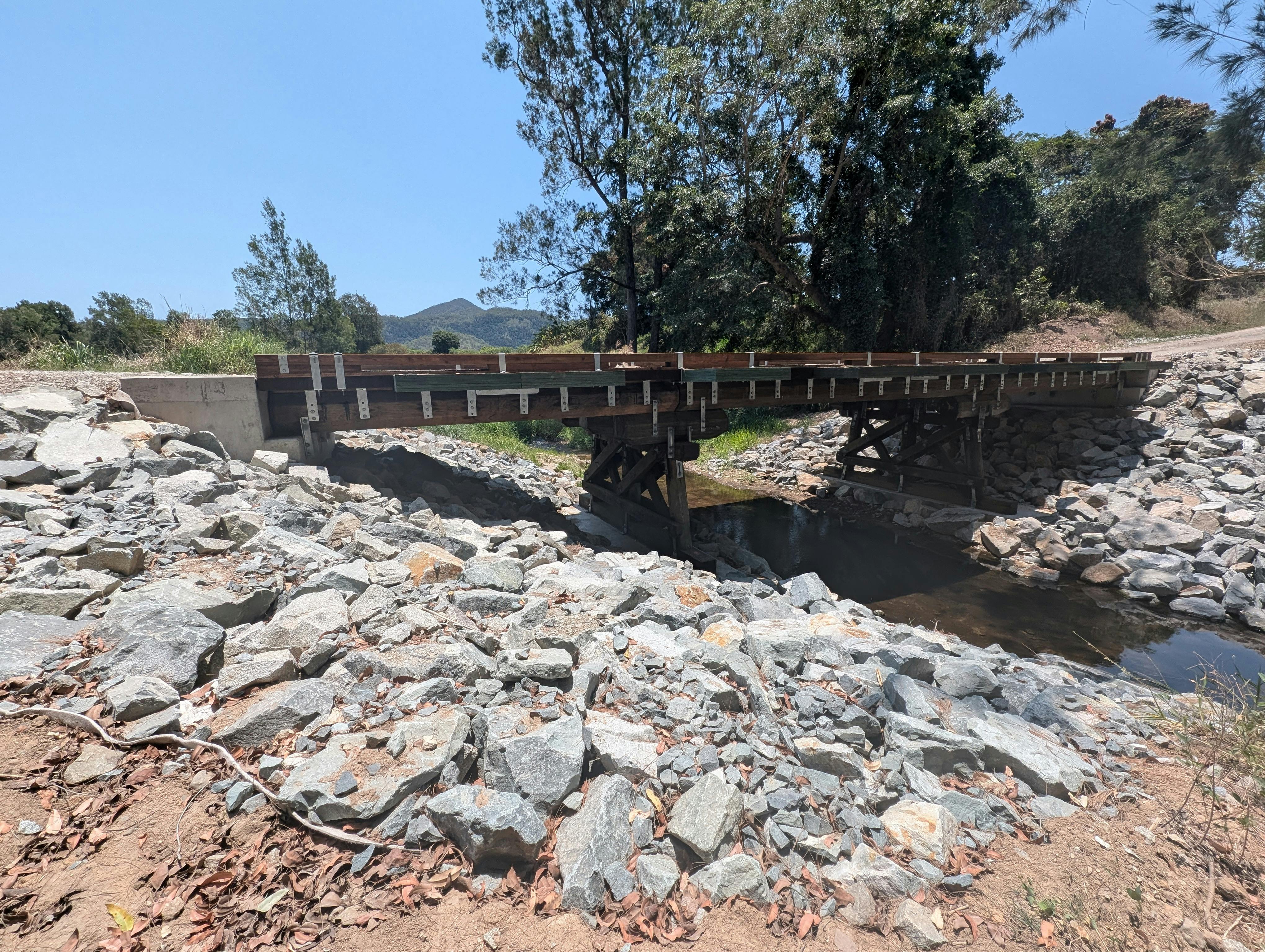

Palm Tee Creek Bridge has now been re-opened for use.
The bridge capacity has been restored to a 44 Tonne “T44” truck loading.
Thank you for your patience while these essential works were under way.
Palm Tree Creek Bridge prior to restoration starting
Palm Tree Creek Bridge new structure.
Palm Tree Creek Bridge's new decking prior to re-opening.
Share Project update: October 4, 2024 on Facebook
Share Project update: October 4, 2024 on Linkedin
Email Project update: October 4, 2024 link
Image of Barren Creek Bridge during demolition.The demolition of Barren Creek Bridge has now been completed.
To accommodate the increased traffic on the detour route through Barren Creek and Barren Pocket roads, lights have been installed.
Fines and infringement notices have been issued to drivers not obeying the detour signage and lights. The route is regularly monitored by traffic management personnel and Queensland Police to ensure the safety of all road users.
The work is expected to be completed by late-December, 2024, weather permitting.
We appreciate your patience and consideration to other road users, while these essential works are under way.
Share Project update: August 30, 2024 on Facebook
Share Project update: August 30, 2024 on Linkedin
Email Project update: August 30, 2024 link
Emergency road closure notice

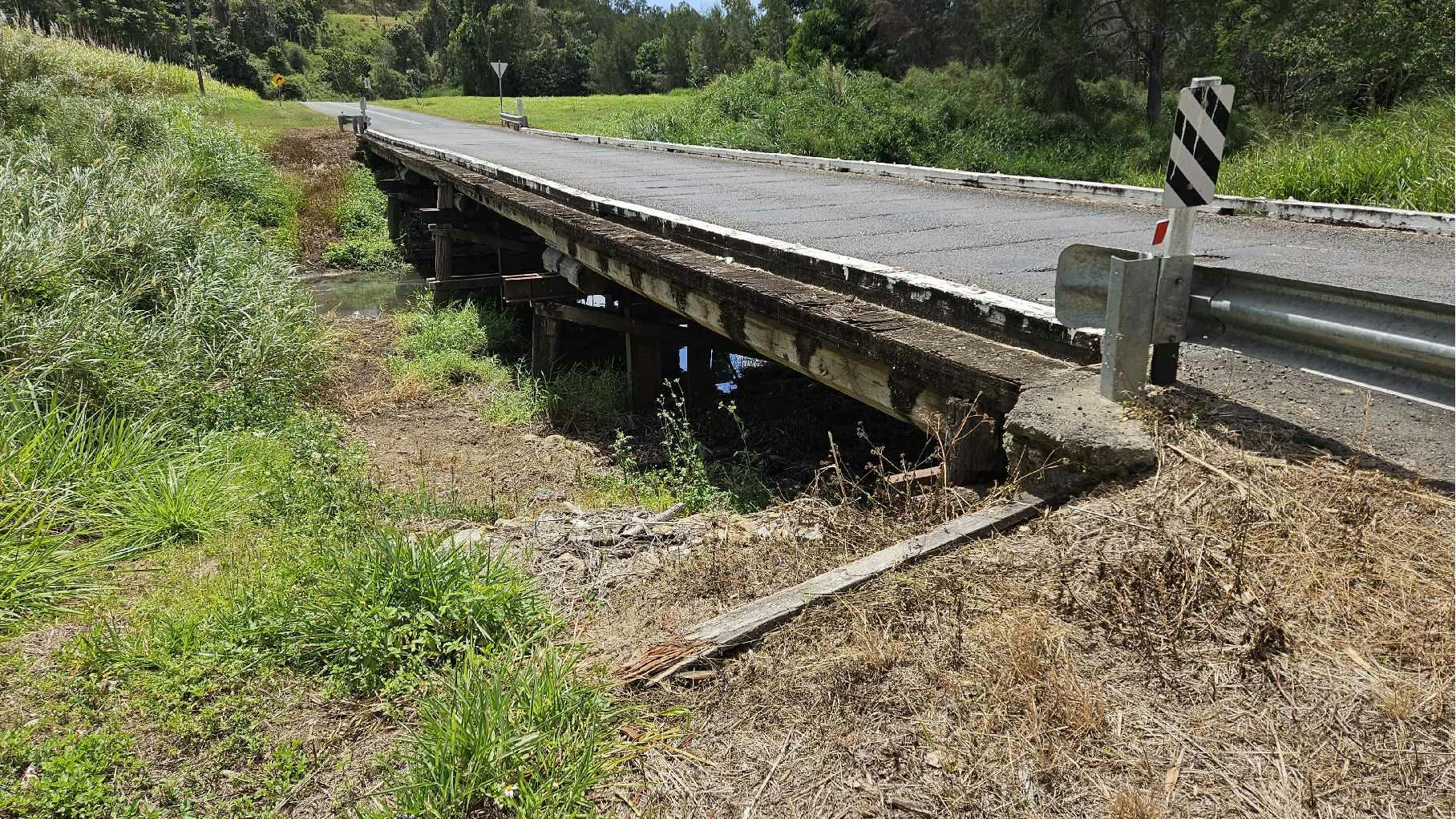

Calen-Mt Charlton Road at Barren Creek Bridge, Calen, is currently closed due to damage to the bridge.
Diversions have been set up via Barron Pocket Road and Barren Creek Road.
Temporary detour signs have been set up and council is working to implement more permanent traffic management and signage over the coming weeks.
Please allow extra time to reach your destination and follow all the signage and temporary traffic light signals that are in place.
The capital works that are scheduled to replace Barren Creek Bridge will begin as planned on Monday, September 9, 2024, weather permitting.
We apologise for any inconvenience caused by this closure and thank you for your cooperation.
